Table of Contents
Introduction
“Mobile home” sounds like something you should be able to hitch up and haul away whenever you want.
Unfortunately, moving one is nothing like moving an RV.
A modern mobile or manufactured home can weigh tens of thousands of pounds. A double-wide must usually be separated into two sections. A triple-wide may require three separate transports. Permits, escort vehicles, utility disconnections, foundation work, setup, anchoring, utility reconnection, skirting, steps, decks, awnings, and repairs may all be separate expenses.
That leads to the single most important thing to understand about mobile home moving costs:

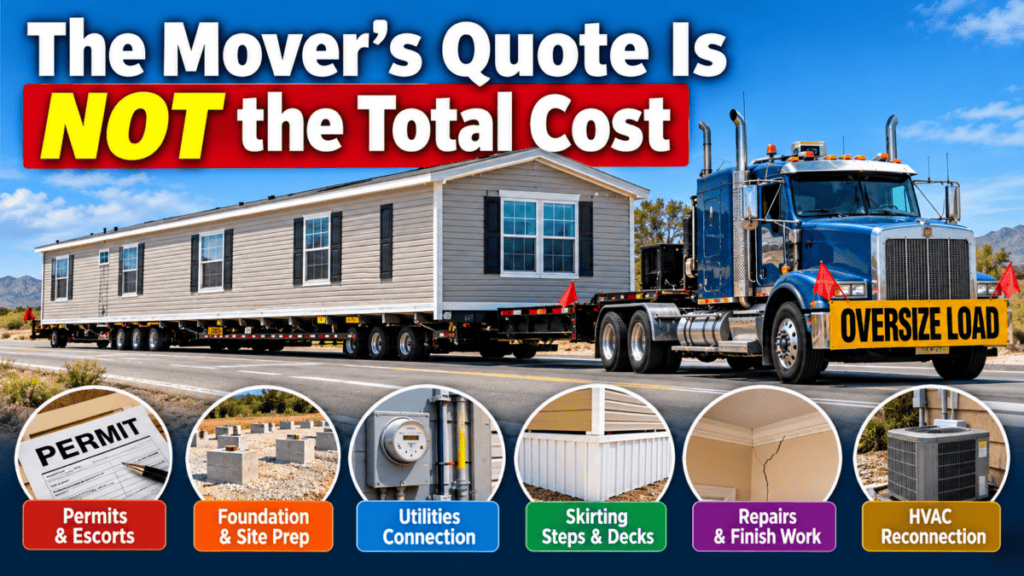

The mover’s quote is NOT necessarily the total cost of moving the home.

In 2026, a relatively straightforward mobile home relocation might cost several thousand dollars. A full-service single-wide move commonly reaches roughly $5,000 to $10,000, while relocating a double-wide can easily reach roughly $8,000 to $18,000 or more. Triple-wides and complicated long-distance moves can cost substantially more.
But even those numbers may not represent the true project cost.
If you are moving the home onto undeveloped private land and need a foundation, grading, electrical service, water, sewer or septic, steps, skirting, and other work, the final expense can reach $20,000, $30,000, $40,000 or considerably more.
This guide explains the entire process from the moment the home leaves its current location until it is installed, connected, inspected, weather-tight, and usable at the new site.
Video Guide Overview

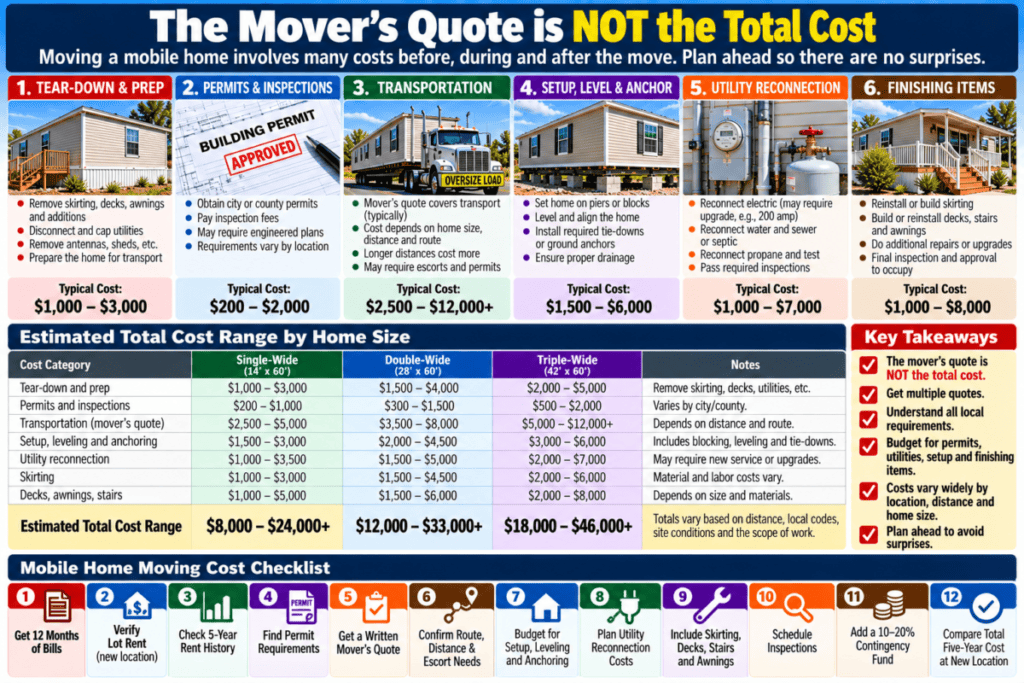

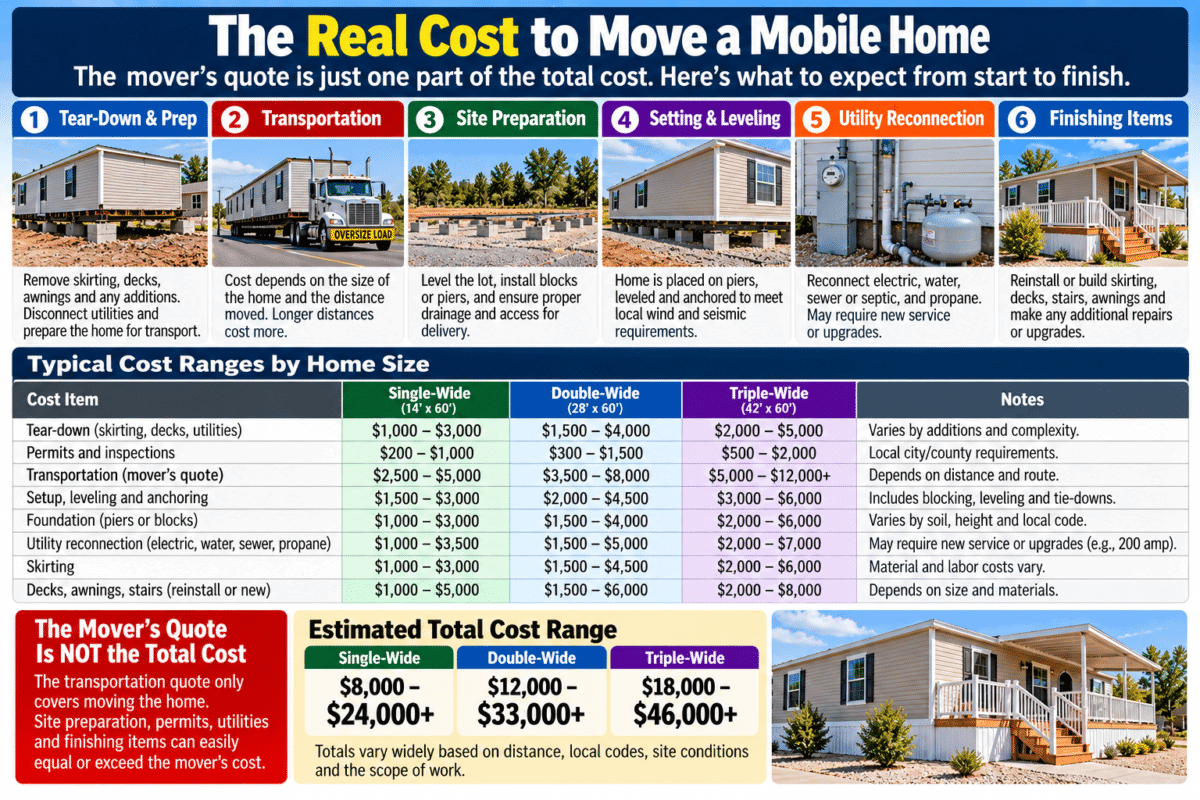

The Short Answer: How Much Does It Cost to Move a Mobile Home?
There is no single national price because people use the phrase “move a mobile home” to describe three very different projects.
| Type of Move | Single-Wide | Double-Wide | Triple-Wide |
|---|---|---|---|
| Transport Only | About $1,000–$5,000+ | About $2,000–$7,000+ | About $3,000–$10,000+ |
| Full-Service Move | About $5,000–$10,000+ | About $8,000–$18,000+ | About $12,000–$25,000+ |
| True All-In Relocation | Often $8,000–$25,000+ | Often $15,000–$40,000+ | Often $20,000–$50,000+ |
These are planning ranges, not quotes. A move between two prepared mobile home park spaces may stay fairly close to the mover’s full-service price. Moving the exact same home onto raw land could require tens of thousands of dollars of additional site and utility work.
That is why asking, “How much does it cost to move a double-wide?” is only the beginning of the conversation.
What Does “Moving a Mobile Home” Actually Mean?
Before comparing prices, determine what the quote actually includes.
Transport-Only Move
A transport-only move generally assumes the home is already prepared to travel.
Depending on the mover and situation, transportation may include little more than:
- Connecting the home to the towing equipment
- Transporting it over the approved route
- Delivering it to the destination
It may not include removing skirting, disconnecting utilities, removing porches, preparing axles, obtaining every required permit, setting the home, reconnecting utilities, or rebuilding anything at the destination.
Full-Service Move
A full-service mover may handle much more, including:
- Preparing the home for transportation
- Separating sections of a multi-section home
- Transporting the home
- Obtaining transportation permits
- Arranging escort vehicles
- Positioning the home at the destination
- Joining sections
- Blocking and leveling
- Anchoring or tie-down work
But the definition of “full service” varies by company.
Never assume something is included because the salesperson used that phrase.
True All-In Relocation
This is the number I believe homeowners really need to calculate.
It includes everything required to go from:
Home at Location A → legally usable home at Location B.
That may include:
Disconnect → prepare → separate → transport → prepare site → foundation → set → join → level → anchor → reconnect utilities → repair → skirt → install steps/decks → inspect → occupy.

Why Mobile Home Moving Prices Vary So Much
Two homes traveling the same distance can have dramatically different moving costs.
The major variables include:
- Single-wide, double-wide, or triple-wide construction
- Length and width of each section
- Weight
- Distance
- Number of states crossed
- Route restrictions
- Bridge and overhead clearances
- Escort vehicle requirements
- Condition of the home
- Condition or availability of axles, wheels, tires, and hitch equipment
- Ease of access at the existing site
- Ease of access at the destination
- Whether decks, awnings, porches, or additions must be removed
- Whether the new site is already developed
- Foundation requirements
- Utility availability
- Local permitting and inspection requirements
- How much work is included in the mover’s contract
That is why an online calculator can give you a starting point but cannot reliably price your individual move.

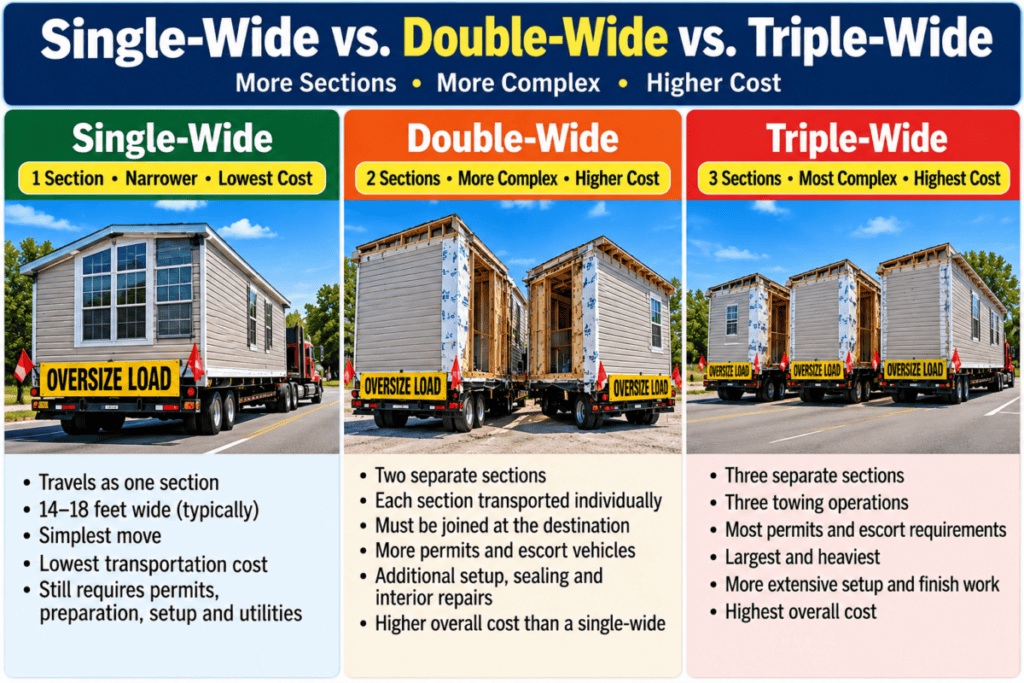

Cost to Move a Single-Wide Mobile Home
A single-wide is generally the least complicated manufactured home to relocate because the home travels as one section.
For 2026 planning purposes, a simple local transport-only move might fall around $1,000 to $5,000 or more.
A more complete move that includes preparation, transportation, setup, leveling, and anchoring can reasonably reach approximately $5,000 to $10,000+.
Then come the expenses that may fall outside the moving company’s contract:
- Utility disconnection
- Site grading
- Foundation work
- Electrical service
- Water connection
- Sewer or septic
- HVAC reconnection
- Skirting
- Steps and landings
- Decks and porches
- Awnings or carports
- Interior and exterior repairs
- Inspections
A move into a prepared park space can therefore be very different financially from placing the same single-wide on vacant land.
Cost to Move a Double-Wide
A double-wide is not simply a heavier single-wide.

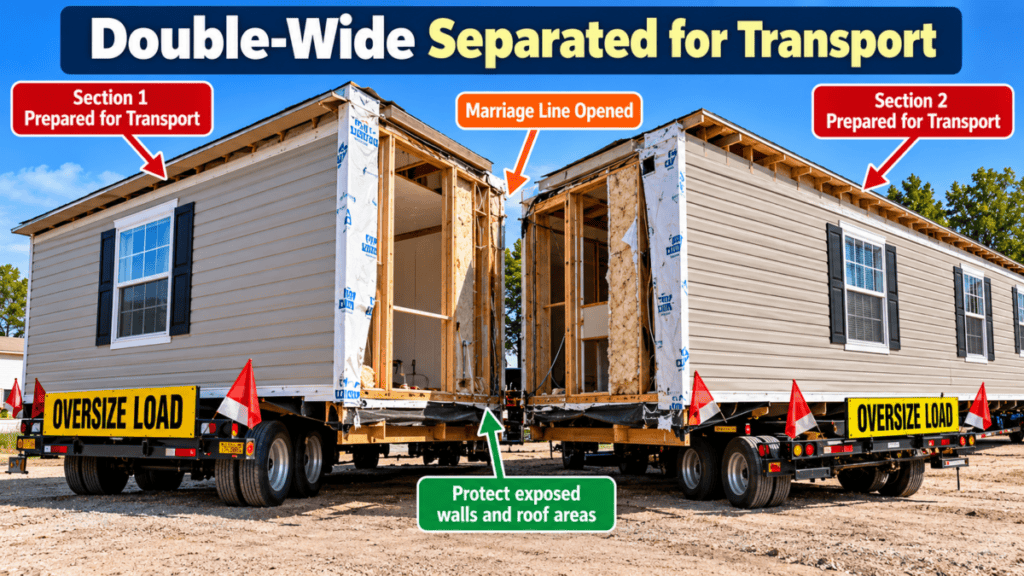

It is generally two separate transportation projects that must become one house again at the destination.
Work can include:
- Opening and preparing the marriage line
- Separating the two sections
- Protecting exposed walls and roof areas
- Preparing both sections for road transportation
- Transporting two sections
- Setting both sections accurately
- Reconnecting structural components
- Sealing the marriage line
- Reconnecting roofing and weather barriers
- Repairing interior trim, drywall, paneling, and flooring
A full-service double-wide relocation commonly reaches approximately $8,000 to $18,000+, and complicated projects can exceed that substantially.
The true all-in relocation can easily move into the $15,000 to $40,000+ range when foundation and utility work are added.

Cost to Move a Triple-Wide
A triple-wide magnifies many of the double-wide complications.
You may have:
- Three separate transport sections
- Three towing operations
- More permits
- Additional escort requirements
- More extensive marriage lines
- More foundation area
- More setup labor
- More interior and exterior finish work
A full-service triple-wide relocation can easily reach $12,000 to $25,000+, with complex projects costing substantially more.
Do not price a triple-wide by simply multiplying a single-wide quote by three. Some costs overlap, while others increase disproportionately because the installation becomes more complicated.

How Distance Changes Mobile Home Moving Cost
Distance matters, but mobile home moving costs do not necessarily increase in a straight line based on mileage.
Very Short Local Moves
A three-mile move is not necessarily cheap.
The mover still has to:
- Send specialized equipment
- Prepare the home
- Load or hitch it
- Comply with transportation rules
- Travel to the site
- Place the home at the destination
Fixed labor and equipment costs may dominate the price.
10 to 25 Miles
These moves are often relatively straightforward when both sites have good access, but preparation and setup expenses can still dwarf the mileage charge.
25 to 50 Miles
Transportation becomes more significant, but route selection may matter more than the number on the odometer.
50 to 100 Miles
Fuel, driver time, escort requirements, permits, and route planning begin to have a larger effect.
More Than 100 Miles
Long-distance relocation increases exposure to route restrictions, multiple jurisdictions, scheduling problems, overnight requirements, and equipment costs.
Interstate Moves
Crossing a state line can complicate the move further because oversize-load permitting is administered by the individual states.
The Federal Highway Administration explains that the federal government does not issue oversize or overweight permits; those permits are handled by the states. You can review the FHWA oversize and overweight permit information here.
A 40-mile route with difficult bridges, overhead lines, narrow roads, or local restrictions can potentially be more troublesome than a much longer move over an easier route.

Tear-Down and Preparation Costs
Before the home ever moves, somebody has to make it movable.
Potential preparation work includes:
- Disconnecting electricity
- Disconnecting water
- Disconnecting sewer or septic
- Disconnecting gas or propane
- Disconnecting HVAC equipment
- Removing skirting
- Removing steps
- Removing decks and porches
- Removing awnings and carports
- Removing attached rooms or additions
- Separating multi-section homes
- Protecting marriage-line openings
- Preparing the hitch
- Installing or inspecting axles
- Installing or inspecting wheels and tires
Ask who performs each job.
The mobile home transporter may do some of it. Other items may require electricians, plumbers, HVAC contractors, demolition crews, or general laborers.
Axles, Wheels, Tires, and the Hitch Can Become Expensive Surprises
This is one of the areas many homeowners never think about until the mover inspects the home.
When manufactured homes are originally installed, transportation equipment may be removed, stored, reused, or left underneath the home.
Even when wheels and tires are still present, tires that have spent many years exposed to heat, weather, and age may no longer be safe for highway transportation.
Axles may also have been removed or disconnected.
A mover therefore needs to determine whether the home is actually road-ready before giving you a meaningful transportation quote.
Do not assume that because the home arrived on wheels 25 years ago, it can leave on those same wheels today.

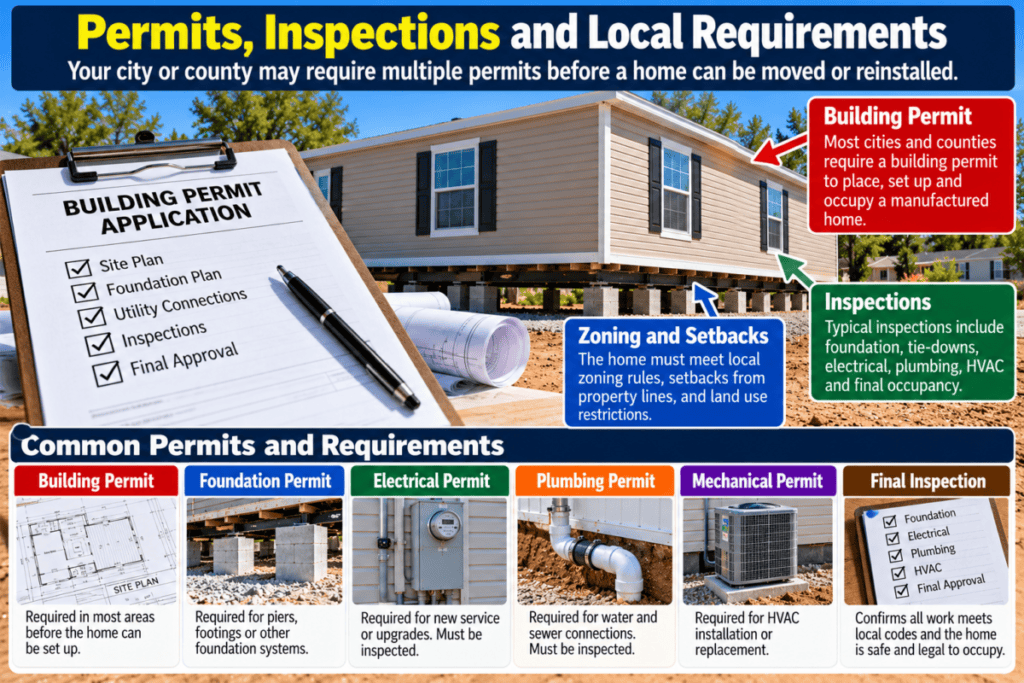

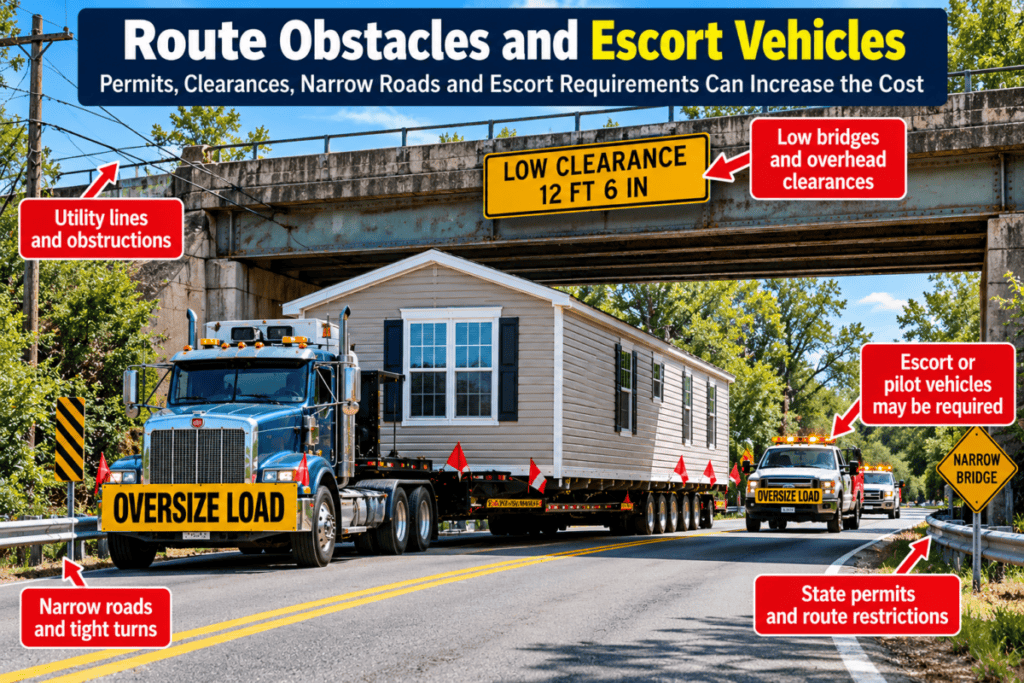

Permits, Routes, and Escort Vehicles
A manufactured home is usually an oversize load.
The federal highway system generally uses 102 inches as the normal commercial-vehicle width limit, and manufactured housing wider than that may move under special state permits.
Requirements vary by location and can involve:
- Single-trip permits
- Oversize permits
- Route approval
- Pilot or escort vehicles
- Travel-time restrictions
- Daylight-only travel
- Bridge restrictions
- Construction-zone restrictions
- Height restrictions
- Police assistance in unusual situations
Never assume a mover’s advertised base price includes every permit and escort charge.
Ask for those items in writing.

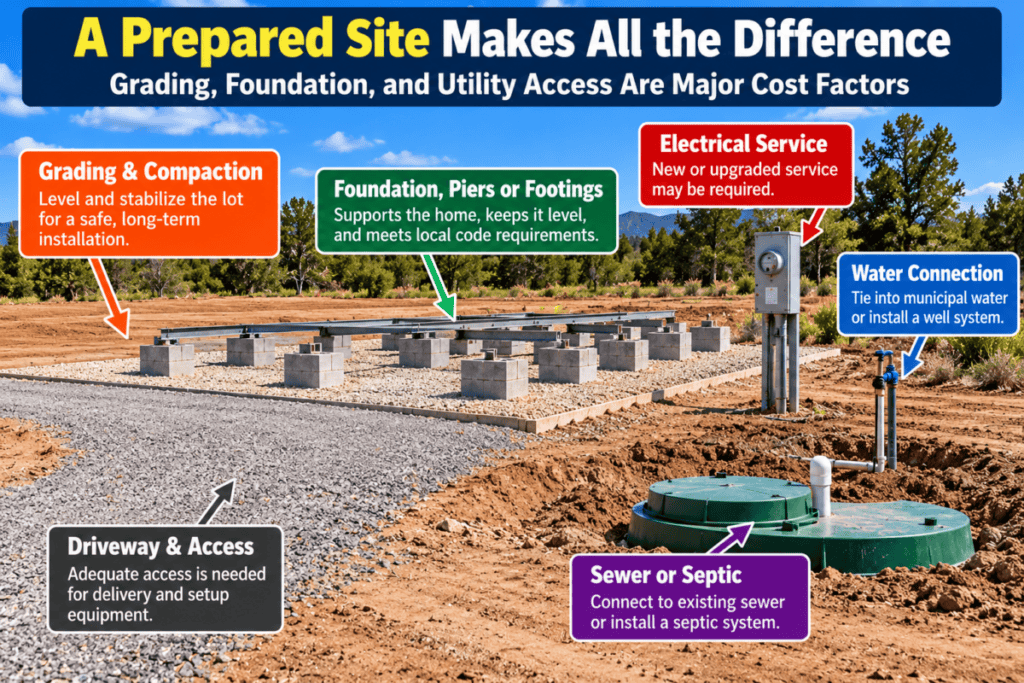

The New Site May Cost More Than Moving the Home
This is where many relocation budgets fall apart.
People find inexpensive land and think they have found an inexpensive place to put a mobile home.
But raw land is not a homesite.
Depending on the property, you may need:
- Clearing
- Grading
- Compaction
- Drainage work
- Driveway or access improvements
- A foundation system
- Footings or piers
- Anchoring
- Electrical service
- Water service
- Sewer connection
- Septic system
- Well
- Propane system
- Utility trenches
- Permits
- Engineering
- Inspections
A cheap lot can therefore become an expensive destination very quickly.
If you are still evaluating foundation choices, see our detailed guide to mobile home foundation types and costs.

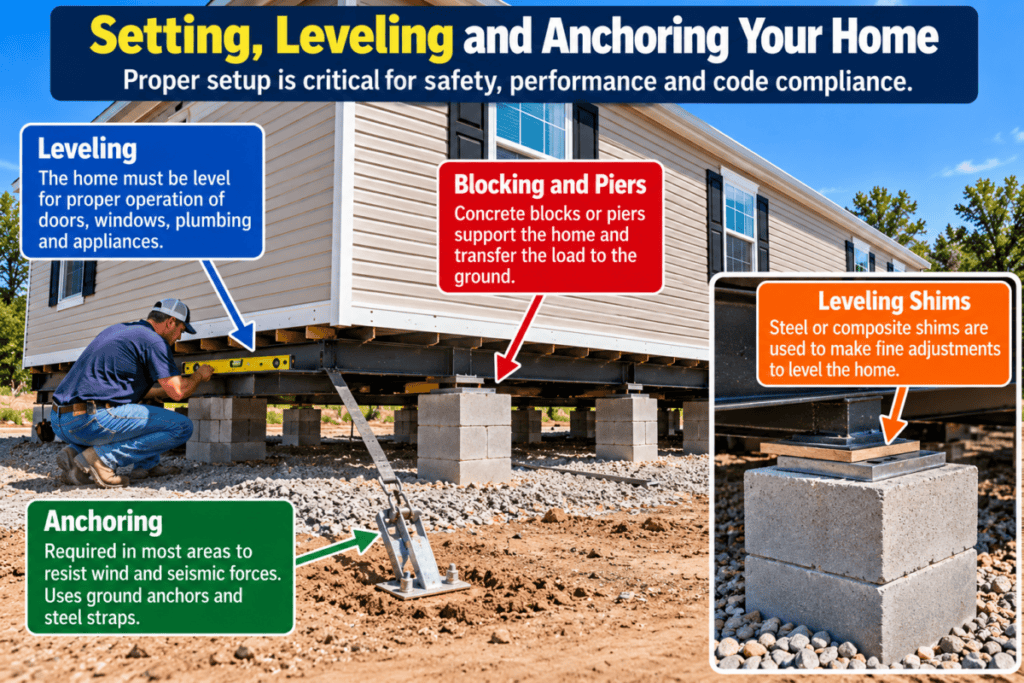

Foundation, Setup, Leveling, and Anchoring
Once the home reaches the property, the job is nowhere near finished.
The home has to be positioned and supported correctly.
Depending on the installation, that may involve:
- Footings
- Concrete or engineered supports
- Piers or blocking
- Precise leveling
- Anchoring
- Tie-down systems
- Joining multiple sections
- Structural connections
- Weather sealing
- Roof connection
HUD’s manufactured-home installation standards include requirements relating to foundations, drainage, blocking, leveling, and anchoring. HUD also states that manufactured homes subject to its installation standards must be secured against wind using approved anchoring or foundation systems.
You can review HUD manufactured housing information here.
For a much deeper explanation of leveling, see our mobile home leveling cost and warning-sign guide.

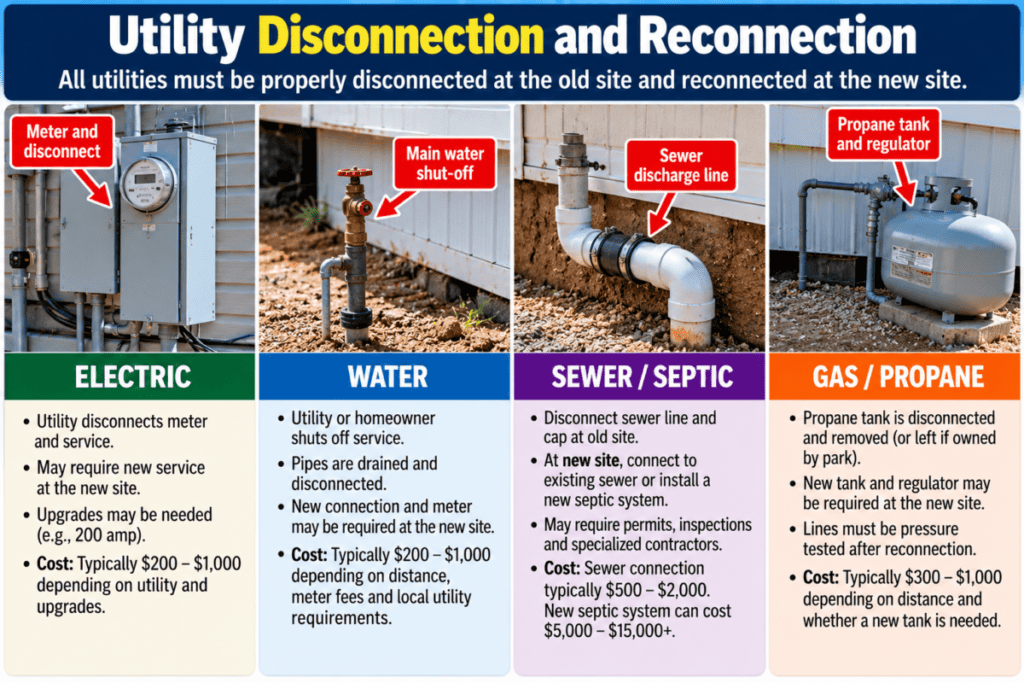

Utility Reconnection Costs
A home sitting on its foundation without utilities is still not a usable home.
Electricity
If electrical service already exists near the home and meets current requirements, reconnection may be relatively simple.
If the property needs a new service panel, trenching, meter location, conduit, or utility-company upgrades, the price can rise quickly.
Water
In a mobile home park, a water connection may be close to the home.
On private land, you may need trenching, pipe, a meter connection, or even a well.
Sewer and Septic
A park space or previously developed site may already have a usable sewer connection.
Vacant land may require a septic system or a long connection to municipal sewer.
This alone can become one of the largest expenses in the entire project.
Natural Gas or Propane
If the home uses gas appliances, the fuel system must be safely reconnected or installed.
HVAC
Split HVAC systems often have exterior equipment that must be disconnected, transported, installed, electrically connected, and professionally recommissioned.
These jobs are frequently performed by contractors other than the mobile home transporter.

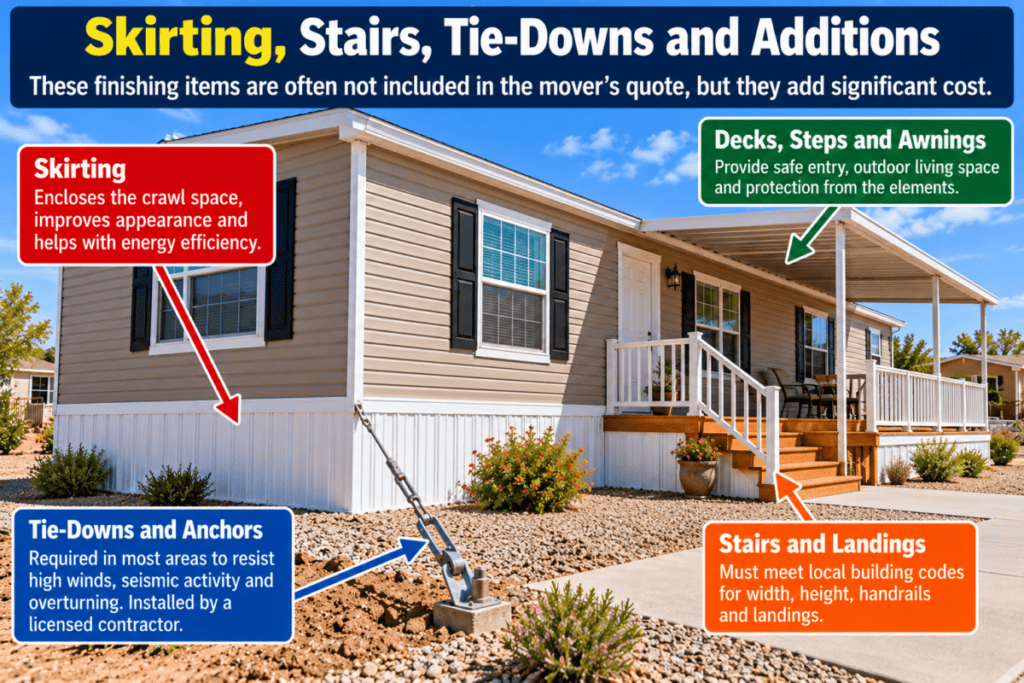

Skirting, Steps, Decks, Porches, Awnings, and Finish Work
These costs are easy to dismiss because none of them moves the house down the highway.
But many are required to turn the relocated structure back into a usable home.
Skirting
Existing skirting frequently does not transfer well because pieces were cut to the old site’s exact height and grade.
Plan for the possibility that new skirting will be necessary.
Steps and Landings
You need safe access to exterior doors, and local code may specify landing, stair, guardrail, and handrail requirements.
Decks and Porches
An existing deck may cost more to dismantle, transport, modify, and rebuild than expected.
Sometimes rebuilding is the smarter choice.
Awnings and Carports
Good aluminum awnings can have meaningful value, so saving and reinstalling them may make economic sense.
But dismantling and reinstalling large structures requires additional labor and transportation.
Interior and Exterior Repairs
Moving a manufactured home can create:
- Cracked drywall
- Separated trim
- Flooring damage
- Loose siding
- Roof damage
- Plumbing problems
- Marriage-line finish repairs
- Doors that need adjustment
I recommend maintaining a contingency fund instead of assuming the home will arrive without needing any repair work.

Can Your Mobile Home Even Be Moved?
Before spending money on destination plans, determine whether the home is a realistic relocation candidate.
The question is not simply, “How old is it?”
A mover should consider:
- Frame condition
- Floor and subfloor condition
- Water damage
- Roof condition
- Structural modifications
- Additions
- Attached porches or rooms
- Previous moves
- Axle condition
- Availability of transportation equipment
- Overall structural integrity
- Destination rules
An older home in excellent structural condition may be a much better moving candidate than a newer home with severe water or floor damage.
For a detailed discussion of this issue, read How Old Is Too Old for a Mobile Home?
You may also want to review How Long Do Mobile Homes Last? when evaluating whether investing significant relocation money into an older structure makes economic sense.
What About Mobile Homes Built Before June 15, 1976?
June 15, 1976 is an important dividing line in manufactured housing.
Homes built before that date are technically mobile homes. Homes manufactured under the federal standards that took effect beginning June 15, 1976 are manufactured homes.
HUD explains that manufactured homes produced after June 15, 1976 must comply with the federal Manufactured Home Construction and Safety Standards and carry certification labels on their transportable sections.
That does not mean federal law automatically prohibits every pre-1976 mobile home from ever being moved.
However, an older pre-HUD home may encounter:
- Destination restrictions
- Mobile home park age restrictions
- Local installation requirements
- Insurance difficulty
- Financing difficulty
- Structural concerns
- Transportation concerns
- Poor economics
For example, FHA financing generally requires an eligible manufactured home to have been built in compliance with the federal standards beginning June 15, 1976.
Before purchasing an older home with the intention of moving it, investigate both the home and the destination.

Real-World Example: A $650 Move Became a $19,100 Project
This is the best example I can give of why the mover’s quote and the relocation cost are not the same thing.
In one of our own projects, we bought a property that had an old, deteriorated mobile home on it. The old home was no longer worth renovating, so we removed it and purchased a newer 16-by-60 home to install on the property.
The replacement home only had to travel approximately three miles.
The mover charged us just $650 to physically move the home.
If someone had asked, “What did it cost you to move the mobile home?” it would have been tempting to say $650.
That answer would have been completely misleading.
| Project Item | Our Cost |
|---|---|
| Old home tear-down and removal | $2,500 |
| Permit-pulling service | $300 |
| Compact and grade lot | $600 |
| Trench and connect water line | $450 |
| New electrical box, trenching and hookup | $1,400 |
| Testing of original septic tank | $250 |
| New septic tank and hookup | $4,500 |
| Mover — approximately three miles | $650 |
| Cement pier foundation and tie-downs | $2,200 |
| Skirting | $1,650 |
| Steps | $500 |
| Awning on one side | $3,700 |
| Inspections | $400 |
| TOTAL PROJECT COST | $19,100 |
These are historical costs from one of our own projects and should not be interpreted as current 2026 contractor pricing.
The lesson is much more important than the individual dollar amounts.
The $650 transportation bill represented only a tiny portion of what it actually cost us to relocate and install the home.
The property needed electrical work, septic work, grading, foundation work, skirting, steps, an awning, permits, and inspections.
That is the number homeowners need to understand before buying a mobile home with plans to relocate it.
Three Example Mobile Home Moving Scenarios
Scenario A: Single-Wide Moved 20 Miles Between Prepared Sites
Imagine a sound single-wide moving from one developed mobile home site to another.
The utilities are nearby, access is easy, no major foundation construction is needed, and the home does not require significant repairs.
A reasonable planning budget might be somewhere around $5,000 to $9,000.
This is the type of relocation where the move can sometimes remain relatively economical.
Scenario B: Double-Wide Moved 50 Miles With Tear-Down and Setup
Now consider a double-wide that must be separated, transported in two sections, reset, rejoined, leveled, anchored, and repaired at the marriage line.
A planning range around $10,000 to $18,000+ would not be surprising before major new utility or land-development expenses.
Scenario C: Older Double-Wide Moved Onto Undeveloped Private Land
This is where people get into financial trouble.
The homeowner gets what appears to be an affordable transportation quote.
Then the project needs:
- Home preparation
- Two-section transportation
- Permits
- Site clearing
- Grading
- Foundation
- Electrical service
- Water
- Septic
- Setup
- Anchoring
- Skirting
- Steps
- Interior repairs
A project like this can reach $25,000, $40,000, $50,000 or considerably more depending on the property.
At that point, the real question may no longer be, “Can I move this home?”
It becomes:
“Does moving this particular home make financial sense?”

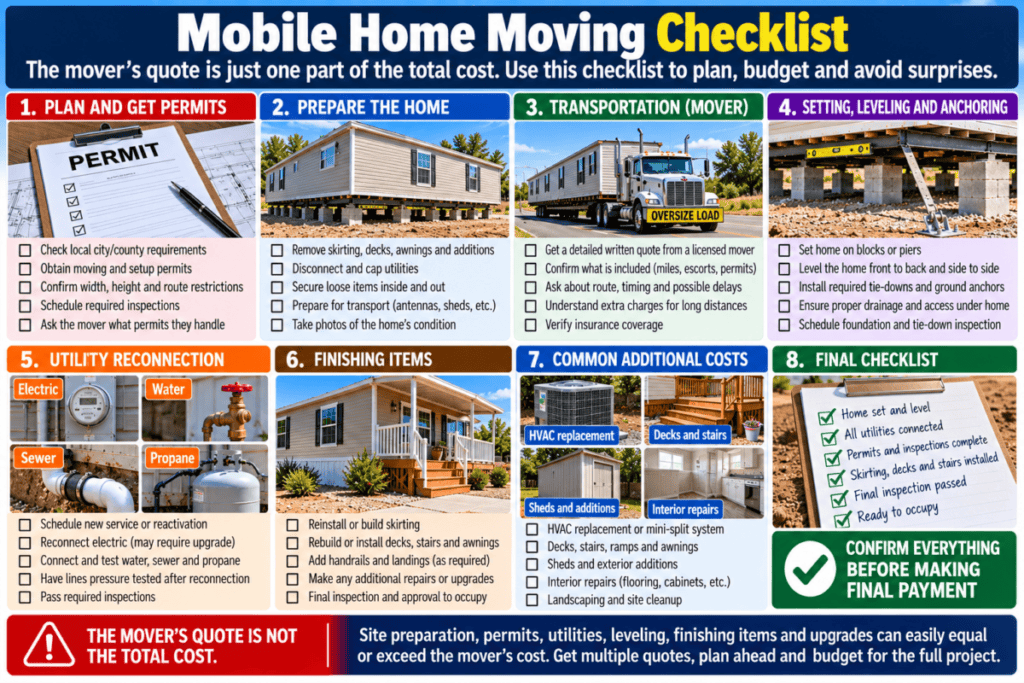

The True Mobile Home Relocation Cost Checklist
| Cost Component | Single-Wide | Double-Wide | Triple-Wide | Always Included in Mover Quote? |
|---|---|---|---|---|
| Home tear-down/preparation | Possible | More extensive | Most extensive | No |
| Transportation | 1 section | 2 sections | 3 sections | Usually |
| Transportation permits | Possible | Likely | Likely | Verify |
| Escort vehicles | Possible | More likely | More likely | Verify |
| Site preparation | Varies | Varies | Varies | Usually No |
| Foundation | Required | Required | Required | Verify |
| Blocking and leveling | Required | Required | Required | Verify |
| Anchoring/tie-downs | Required as applicable | Required as applicable | Required as applicable | Verify |
| Joining sections | N/A | Required | Required | Verify |
| Electrical | Varies | Varies | Varies | Usually No |
| Water | Varies | Varies | Varies | Usually No |
| Sewer/septic | Varies | Varies | Varies | Usually No |
| HVAC | Varies | Varies | Varies | Usually No |
| Skirting | Often needed | Often needed | Often needed | Usually No |
| Steps/decks | Often needed | Often needed | Often needed | Usually No |
| Finish repairs | Possible | Likely | Likely | Usually No |
Transportation is only one row in the table.
Questions to Ask a Mobile Home Mover Before Signing Anything
Do not accept a one-line quote that simply says “move home — $8,500.”
Ask these questions:
- Exactly what does this price include?
- Who prepares the home for transportation?
- Who disconnects utilities?
- Who removes the skirting?
- Who removes decks, porches, steps, awnings, and carports?
- Who separates the sections of a double-wide or triple-wide?
- Who provides or repairs axles, wheels, tires, and hitch components?
- Who obtains transportation permits?
- Are permit fees included in the quote?
- Are escort or pilot vehicles included?
- Is route planning included?
- Does the price include setting the home at the destination?
- Does setup include blocking and leveling?
- Does it include anchors and tie-downs?
- For a multi-section home, who reconnects the sections?
- Who seals and weatherproofs the marriage line?
- Who performs interior marriage-line repairs?
- Who reconnects electricity, water, sewer, gas, and HVAC?
- What insurance does the mover carry?
- What happens if the home is damaged during transportation?
- What conditions can cause the quoted price to increase?
- What work must be completed before the mover arrives?
- What work will remain after the mover leaves?
Get the answers in writing.
How to Find a Mobile Home Mover
One method that has worked well for us is contacting manufactured home dealers in the area.
Dealers regularly have homes delivered and installed, so they usually know which transporters and setup crews are active locally.
Ask more than one dealer.
Then obtain multiple bids and compare scope of work rather than just the bottom-line number.
A $7,000 quote that includes teardown, permits, transport, setup, leveling, and anchoring may actually be cheaper than a $4,500 quote that leaves most of those jobs to you.
When Moving a Mobile Home Does Not Make Financial Sense
This is the calculation many owners avoid because they have already decided emotionally that they want to keep the home.
Instead, compare:
Current value of the home + total relocation cost
against:
- Selling the existing home where it sits
- Buying another used mobile or manufactured home near the destination
- Buying a home already installed on land
- Buying a newer manufactured home
Suppose an older mobile home is worth $20,000 where it currently sits.
If relocating it will cost $30,000 and leave you owning the same aging $20,000 structure, moving may not be the best use of your money.
On the other hand, a high-quality home in excellent condition may absolutely be worth relocating—particularly when replacing it would cost far more.
The point is not that moving is always a bad idea.
The point is:
Do the complete math before making the decision.
Final Mobile Home Moving Cost Checklist
Before committing to a move, work through this sequence:
- Inspect the home.
- Determine whether the structure can safely be transported.
- Verify that the destination will accept the home.
- Check zoning and installation requirements.
- Verify access at both properties.
- Get an itemized mover quote.
- Identify exactly what the mover does not include.
- Price tear-down and preparation.
- Price transportation permits and escorts.
- Price destination grading and site preparation.
- Price the foundation.
- Price electrical service.
- Price water.
- Price sewer or septic.
- Price HVAC work.
- Price setup, leveling, and anchoring.
- Price skirting.
- Price stairs, landings, decks, porches, and awnings.
- Allow money for repairs.
- Allow money for permits and inspections.
- Add a contingency reserve.
- Compare the total against buying another home.

Bottom Line
So, how much does it cost to move a mobile home?
A simple move can cost only a few thousand dollars. A full-service single-wide relocation might run roughly $5,000 to $10,000+. A double-wide can easily reach $8,000 to $18,000+, and larger or more complicated homes can cost substantially more.
But those figures still do not tell you what you really need to know.
The mover’s quote is not necessarily the moving cost.
The number that matters is what you will spend to take the home from its current location and make it legal, level, anchored, connected, weather-tight, accessible, and livable at the new location.
Sometimes that number makes moving an excellent decision.
Sometimes it proves that selling the existing home and purchasing another home near the destination is far less expensive.
Find out which situation you have before the first truck arrives.
This article is based on hands-on experience with manufactured home purchases, relocations, and setup coordination across multiple states. Cost ranges reflect real-world transport quotes, permitting requirements, and buyer-reported outcomes rather than promotional pricing.
